Industrial Electricity and Utility Rates for Manufacturing in Mexico
Across Tetakawi's 60+ manufacturing operations, clients pay an average of $0.117 per kWh for industrial electricity in Mexico. That puts Mexico in the middle of the North American pack: cheaper than Michigan or New York, roughly equal to Tennessee and Illinois, more expensive than Texas or Quebec. The rate is competitive. But the rate is only part of the equation.
What most cost analyses miss is the infrastructure behind the rate. Mexico's national grid expanded transmission capacity by 0.1% in 2022-2023 while industrial demand grew 3.5%. Reserve margins dropped to 3% during peak load in May 2024, half the minimum threshold for stable operation. And 91% of industrial parks across the country have experienced power supply failures. For manufacturers running CNC machines, robotics, and PLCs, the question isn't just what you pay per kilowatt-hour. It's whether the power stays on and stays clean.
Key Takeaway
Mexico's industrial electricity rate averages $0.117–$0.119 per kWh, comparable to Illinois and Tennessee, lower than Michigan ($0.132) or New York ($0.167). Natural gas averages $0.027 per kWh, less than a third of the global average. But rates only tell part of the story. Grid reliability is the real operational variable: 91% of Mexico's industrial parks have experienced power failures, reserve margins hit 3% in May 2024 (6% is the minimum for stable operations), and voltage fluctuations cause cumulative damage to precision equipment. CFE's $8.2 billion grid expansion plan (2025–2030) targets northern manufacturing corridors, but execution will take years. Manufacturers operating within established manufacturing campuses with dedicated electrical infrastructure and professional facilities management face fewer disruptions than standalone operations. Where you operate matters as much as what you pay.
What Manufacturers Actually Pay for Electricity in Mexico
Mexico's industrial electricity runs through the Comisión Federal de Electricidad (CFE), which remains the sole retail supplier even after multiple rounds of reform. CFE uses time-of-use pricing across 30+ tariff categories. The two that matter for manufacturing are GDMTO (medium demand, under 100 kW) and GDMTH (high demand, over 100 kW, where most manufacturing sits).
The rate structure breaks into three tiers based on when you consume power:
CFE RATE STRUCTURE
- Base period (midnight to 6 AM)
- The lowest rate, roughly 30–40% below peak.
- Intermediate period (daytime hours, varies by season)
- The rate most manufacturers pay for the bulk of their consumption.
- Peak period (evening hours, typically 6–10 PM in winter, 8–10 PM in summer)
- The highest rate, where demand charges add up fast.
Operational data across 60+ manufacturers shows a blended average of $0.117 per kWh, including demand charges, time-of-use adjustments, and power factor corrections. Mexico's published medium-power industrial rate sits at $0.119 per kWh. The difference reflects efficiencies that come from campus-level power factor optimization and demand management, rather than leaving each manufacturer to manage independently.
One-time electrical costs also factor into startup budgets. Expect approximately $140 per kVA for peak demand capacity through CFE, plus electrical certification ($3,500–$5,000), environmental studies ($1,500–$5,000), and utility bonds ($1,000–$5,000). Direct CFE billing requires a dedicated substation. A standalone operation must procure and build its own; in a manufacturing campus with dedicated industrial space, that infrastructure comes built in.
There's also a sequencing reality that first-time manufacturers often miss. Before production equipment arrives, the building needs electrical power systems, compressed air, water supply, and extraction systems prepared and tested. In a standalone setup, coordinating these across multiple contractors and government agencies adds months. In an established campus, the infrastructure team handles this as part of a standard launch sequence.
How Mexico's Industrial Electricity Rates Compare

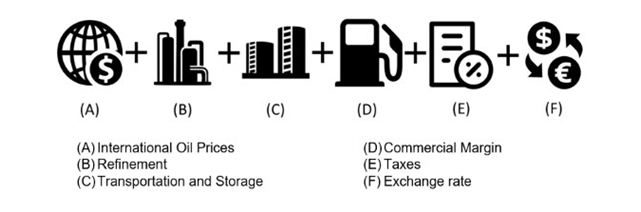

Mexico's industrial electricity rate of $0.117 per kWh sits in the middle of the North American range. Manufacturers evaluating Mexico typically benchmark against wherever they operate now. Here's what that comparison looks like using 2025 published rates and operational data from Mexico:
Industrial Electricity Rates: North America (USD/kWh, 2025)
Sources: EIA (U.S. states), Hydro-Québec comparative report (Canada), CFE published tariffs and Tetakawi operational data (Mexico).
| Location | Industrial Rate (USD/kWh) |
|---|---|
| Quebec, Canada | $0.078 |
| Texas | $0.085 |
| Illinois | $0.108 |
| Tennessee | $0.117 |
| Mexico (operational avg.) | $0.117 |
| Mexico (CFE medium-power rate) | $0.119 |
| Michigan | $0.132 |
| Ontario, Canada | $0.138 |
| New York | $0.167 |
Mexico sits in the middle. Quebec and Texas are cheaper, thanks to subsidized hydro and deregulated gas markets. But Mexico is 12% less than Michigan, 15% less than Ontario, and 30% less than New York.
Regional variation within Mexico matters too. Operations along the northern border (Sonora, Chihuahua, Tamaulipas) often pay less than the national average because of proximity to U.S. natural gas imports and cross-border grid interconnections with Texas and California. Southern states like Yucatán and Chiapas face higher rates due to limited transmission capacity. Even within northern Mexico, the differences are significant. Monterrey faces power and water shortages alongside labor competition and limited Class A industrial space. Saltillo, 80 kilometers away, connects to the same supply chains and border crossings without those constraints.
For a 50,000-square-foot operation with standard industrial power requirements, the electricity rate difference between Mexico and Michigan adds up to roughly $50,000–$80,000 per year. Meaningful, but not transformative on its own. The real cost variable isn't the rate. It's downtime.
The Rate Is Only Half the Story: Grid Reliability and Power Quality
This is what most cost analyses leave out. Mexico's electricity rate looks competitive on paper. The infrastructure delivering that electricity is where the risk lives.
91%
of industrial parks have experienced power failures
AMPIP 2023
3%
grid reserve margin, May 2024 (6% minimum for stability)
Admonitor
$8.2B
CFE grid expansion plan, 2025–2030
Proyectos México
During May 2024, Mexico's national grid reserve margin dropped to 3%, exactly half the 6% threshold that grid operators consider the minimum for stable operations. CFE's actual investment in transmission and distribution has consistently fallen short of what its own planning mechanism (PRODESEN) calls for, contributing to a cumulative deficit of over 4,370 km of transmission lines not built between 2018 and 2022. Grid transmission capacity expanded just 0.09–0.10% in 2022-2023, while industrial electricity demand grew 3.4–3.5% over the same period.
The Infrastructure Gap: Annual Growth Rates (2022–2023)
Source: PRODESEN, CFE annual reports.
The result: 91% of Mexico's industrial parks have experienced power supply failures, according to industry surveys. The Jalisco industrial corridor alone estimated $12–15 million in losses from the May 2024 blackouts. National manufacturing losses during major outage events reach an estimated $200 million per hour.
Full blackouts get the headlines, but voltage sags, surges, and micro-cortes (brief interruptions lasting milliseconds to seconds) cause cumulative harm to precision equipment. CNC machines lose positioning data. Robotics controllers fault and require recalibration. PLCs reset mid-cycle. These are operational realities that manufacturers in standalone facilities deal with regularly, often without realizing the source of their quality variance or equipment degradation.
CFE has announced an $8.2 billion transmission expansion plan for 2025–2030, including 275 new transmission lines and 524 substations. Ninety-two of those projects specifically target northern manufacturing corridors. That's a positive signal, but infrastructure build-out takes years, and CFE's execution has historically lagged behind its planning.
How Infrastructure Model Affects Utility Reliability
The reliability picture varies depending on how your operation is set up. Where and how you operate determines how much infrastructure risk you absorb.
A standalone operation manages its own electrical infrastructure from the ground up: procuring a substation, establishing a direct relationship with CFE, sourcing and maintaining backup power systems, monitoring power quality, and responding to grid events independently. Manufacturers moving to Mexico for the first time often underestimate how different this is from plugging into a U.S. utility grid.
A Manufacturing Campus operates on a different model. Because a campus aggregates demand across dozens of manufacturers, the economics justify infrastructure that no single operation would typically build alone:
Standalone Operation
Procures own substation. Establishes individual CFE relationship. Sources and maintains backup power independently. Monitors power quality building-by-building. Responds to grid events alone.
Manufacturing Campus
Dedicated substations and distribution designed for industrial loads. Decades-long CFE relationships with priority response. On-site facilities management teams. Campus-wide power factor optimization and load balancing.
Dedicated electrical infrastructure. Campus-level substations and distribution systems designed for industrial loads, not shared with residential or commercial users who create the voltage fluctuations that damage equipment. Some campuses are investing further: one Sonora location is constructing a dedicated in-park substation specifically to serve its manufacturing tenants.
Established CFE relationships. When grid events happen, response time matters. A campus with decades of operational history and direct CFE coordination gets priority attention that a new standalone operation does not.
Ongoing facilities management. On-site teams maintain shared infrastructure and critical systems, including power quality monitoring, backup system maintenance, and preventative maintenance programs. Equipment degradation from voltage irregularities gets caught before it becomes a production problem.
Campus-level demand management. Power factor optimization, peak demand coordination, and load balancing happen across the entire campus, not building by building. This creates rate efficiencies that individual operations don't capture, which is part of why the operational average ($0.117/kWh) runs slightly below the published CFE rate ($0.119/kWh).
None of this makes Mexico's grid challenges disappear. It means the impact on your production line is materially different depending on whether you're operating inside dedicated industrial infrastructure or absorbing grid variability on your own.
Mexico's 2025 Energy Reform: What Manufacturers Should Know
In March 2025, the Sheinbaum administration passed the most significant energy reform since the 2013 liberalization, and it moves in the opposite direction.
The key changes:
CFE generation floor. CFE is now required to generate at least 54% of Mexico's total electricity. Before the reform, private generators had been steadily increasing market share. This reversal prioritizes state-controlled generation over private competition.
Regulatory consolidation. The independent energy regulators (CRE and CNH) were dissolved and replaced by a centralized National Energy Commission (CNE) reporting to the executive branch. CENACE continues as the system operator, but regulatory oversight now flows through SENER rather than independent bodies.
Renewable targets with CFE control. Mexico maintains its clean energy commitments, but private renewable projects face new constraints. Self-supply contracts, previously used by large manufacturers to procure cheaper renewable energy directly, are under legal challenge.
WHAT THIS MEANS IN PRACTICE
For manufacturers in a shelter or IMMEX operation, day-to-day electricity purchasing hasn't changed. You still buy from CFE at published tariff rates. The reform affects the generation and wholesale market structure, not the retail rate structure.
The concern is longer-term. Less private competition in generation could slow capacity additions. Reduced regulatory independence could affect grid investment decisions. CFE's track record of underinvesting relative to its own plans doesn't change because of a regulatory shuffle.
The counterpoint: CFE's $8.2 billion transmission expansion plan specifically targets manufacturing corridors in the north. Ninety-two projects across the northern zone, including Sonora, Chihuahua, Nuevo León, and Tamaulipas, aim to close the demand-infrastructure gap. If executed, this would meaningfully improve reliability in the regions where most cross-border manufacturing operates.
Natural Gas Rates and Pipeline Access
$0.027/kWh
Mexico's industrial natural gas rate, less than a third of the global average ($0.107/kWh)
Industrial natural gas in Mexico averages $0.027 per kWh, less than a third of the global average of $0.107 per kWh. That gap exists because of geography: U.S. pipeline exports to Mexico averaged 6.6 billion cubic feet per day in the first half of 2025, up 5% year-over-year, keeping prices anchored to the U.S. Henry Hub benchmark rather than global LNG pricing.
Availability varies sharply by region. Northern industrial corridors along the border (Sonora, Chihuahua, Coahuila, Nuevo León, Tamaulipas) have extensive pipeline networks connecting directly to U.S. supply. Operations in central or southern Mexico may have limited or no pipeline access, requiring trucked LPG or propane at significantly higher costs.
Pipeline infrastructure continues expanding. The Tula-Villa de Reyes and Saguaro pipelines have added capacity to underserved corridors. For manufacturers with significant thermal processes (heat treatment, molding, furnaces), pipeline gas access should be a binary site selection criterion, not an afterthought.
When evaluating locations, ask specifically: is pipeline natural gas available at the site, or will you rely on trucked fuel? The cost difference between piped gas and trucked LPG can exceed 300%, enough to reshape an entire cost model. The Dallas Federal Reserve tracks U.S. natural gas exports to Mexico as a key indicator of cross-border energy integration.
Water Rates, Availability, and the Growing Risk
Water rates in Mexico are low. Municipal rates average approximately $0.014 per gallon (updated from the 2023 figure of $0.007, reflecting recent rate increases and sewer surcharges). For most manufacturing operations, water is a rounding error in the utility budget.
The risk isn't cost. It's availability.
71% of Mexican territory now faces high or very high water stress, according to 2025 data. In northern manufacturing corridors, where most cross-border operations locate, the situation is acute. Nearly a quarter of Mexico's 653 aquifers are classified as overexploited, a figure that has grown 77% since 2011. Industrial water consumption is projected to grow 15% by 2030 as nearshoring accelerates, putting additional pressure on already strained systems.
Mexico's new water framework treats water as a human right rather than a commodity. The practical implication: new water concessions are harder to obtain, existing concessions face tighter scrutiny, and regulatory risk around water access is increasing.
Manufacturing campuses address this through campus-level water infrastructure: private treatment facilities, water reuse and recycling programs, and established CONAGUA concessions that individual operations would need to secure independently. Some have gone further. One campus in Sonora invested in an on-site desalination plant capable of producing 800 cubic meters of water per day, enough to supply all manufacturing tenants. Another maintains elevated water tanks holding 600,000 liters with an additional 400,000-liter cistern under construction. In water-stressed regions, this kind of infrastructure is the difference between reliable water access and operational disruption.
For water-intensive processes (automotive painting, food processing, semiconductor cleaning), water availability should rank alongside electricity reliability as a site selection criterion.
What This Means for Manufacturers
If you're building a Mexico cost model, electricity and utility rates are the starting point. The rate is real: $0.117/kWh is what manufacturers in established campuses actually pay, and it's competitive with the U.S. industrial Midwest.
But the rate doesn't tell you whether your production line will run without disruption. Three things determine that:
Grid reliability at your specific location. Not the national average, but the infrastructure serving your facility. Northern border regions with CFE grid expansion and cross-border interconnections have different reliability profiles than central or southern Mexico.
Power quality at the point of use. Voltage stability, frequency regulation, and protection from micro-cortes matter more for precision manufacturing than the headline rate. This is infrastructure-dependent.
Water access in a stressed region. The cost is negligible. The availability is not guaranteed, especially for operations outside established campuses with existing water concessions and treatment infrastructure.
The complete guide to manufacturing costs in Mexico covers how utilities fit into the total cost picture alongside labor, logistics, compliance, and startup costs.
The Bottom Line
Mexico's industrial electricity rate is competitive. Natural gas is cheap where pipelines exist. Water is inexpensive but increasingly scarce.
The variable that separates smooth operations from costly disruptions is infrastructure. The gap between Mexico's grid capacity and its industrial demand growth is real, measurable, and not closing quickly. A cost model that stops at rate-times-consumption misses the factor that actually determines operational uptime: the reliability and quality of the power reaching your equipment.
That's why location selection matters as much as rate comparison. Operations where substations are already built, CFE relationships are established, power quality is monitored, and water access is secured have a fundamentally different risk profile than standalone setups. The Manufacturing Campus model exists for exactly this reason, and it's why 60+ manufacturers operate within established campuses today.
The rate is a data point. The infrastructure is a decision.
Build a Predictable Path to Manufacturing in Mexico
Get a detailed cost model for your operation, including utility rates, labor, logistics, and compliance.
Talk to an ExpertFrequently Asked Questions
What is the average industrial electricity rate in Mexico?
Manufacturers in established Mexico operations pay an average of $0.117 per kWh, including demand charges, time-of-use adjustments, and power factor corrections. Mexico's published medium-power industrial rate (GDMTH tariff) sits at $0.119 per kWh. Both figures are comparable to Illinois and Tennessee, and 12–30% lower than Michigan, Ontario, or New York.
How reliable is electricity for manufacturing in Mexico?
Reliability varies significantly by location and infrastructure. Nationally, 91% of industrial parks have experienced power supply failures. The grid's reserve margin dropped to 3% in May 2024, and transmission capacity has not kept pace with demand growth. Manufacturers operating within established manufacturing campuses with dedicated electrical infrastructure and professional facilities management face materially fewer disruptions than standalone operations.
How does Mexico's 2025 energy reform affect manufacturers?
The March 2025 reform requires CFE to generate at least 54% of grid electricity and consolidates independent regulators under the Ministry of Energy. For manufacturers in shelter or IMMEX operations, day-to-day electricity purchasing hasn't changed. You still buy from CFE at published tariff rates. The longer-term concern is whether reduced competition in generation will slow capacity additions and grid investment.
How much does natural gas cost for manufacturing in Mexico?
Industrial natural gas in Mexico averages $0.027 per kWh, less than a third of the global average. Prices stay low because of extensive pipeline connections to U.S. supply, with imports averaging 6.6 billion cubic feet per day. Availability varies by region: northern border states have extensive pipeline infrastructure, while central and southern locations may require trucked fuel at significantly higher costs.
Is water availability a risk for manufacturing in Mexico?
Water rates are low (approximately $0.014 per gallon), but availability is the real concern. 71% of Mexican territory faces high or very high water stress, and nearly a quarter of aquifers are overexploited. Industrial water consumption is projected to grow 15% by 2030. Manufacturing campuses with existing water concessions, treatment facilities, and reuse programs provide more reliable access than standalone operations securing new concessions.
How does operating infrastructure affect utility reliability?
A manufacturing campus aggregates demand across dozens of manufacturers, justifying dedicated substations, established CFE relationships, professional power quality monitoring, and campus-level water treatment. Standalone operations must procure, build, and maintain all of this independently. The campus model doesn't eliminate Mexico's grid challenges, but it materially reduces the impact on individual operations through dedicated infrastructure and institutional coordination.
